Rapidan Service Authority

three counties formed the Rapidan Service Authority in 1969
three counties formed the Rapidan Service Authority in 1969
Source: Rapidan Service Authority, Webshare Portal

Orange, Madison and Greene counties organized the Rapidan Service Authority in 1969 to provide regional water, sewer, and solid waste services. Each county appointed two people to the board of the authority.1

In Greene County, the Rapidan Service Authority funded construction of a water system to serve the Ruckersville and Stanardsville areas. The authority was also responsible for sewer service in the Town of Stanardsville and the surrounding area, plus the commercial area of Route 29 in Ruckersville. The Rapidan Service Authority's water treatment plant on the Rapidan River provided drinking water for the Route 29 corridor near Ruckersville, plus the Route 33 corridor between Ruckersville and Stanardsville.

Greene County began planning construction of a new reservoir in 2000 with Project 2000 Comprehensive Water Supply Plan, anticipating groundwater could not supply the future population as the county became a bedroom community north of Charlottesville. After a major drought in 2002, the General Assembly mandated in 2005 that jurisdictions prepare 50-year water supply plans. Based on the regional water supply study, in 2008 Greene County adopted the White Run impoundment project and construction of a new 3.5 MGD (million gallons per day) water treatment plant as the preferred alternative. Total cost was estimated then at $35 million.

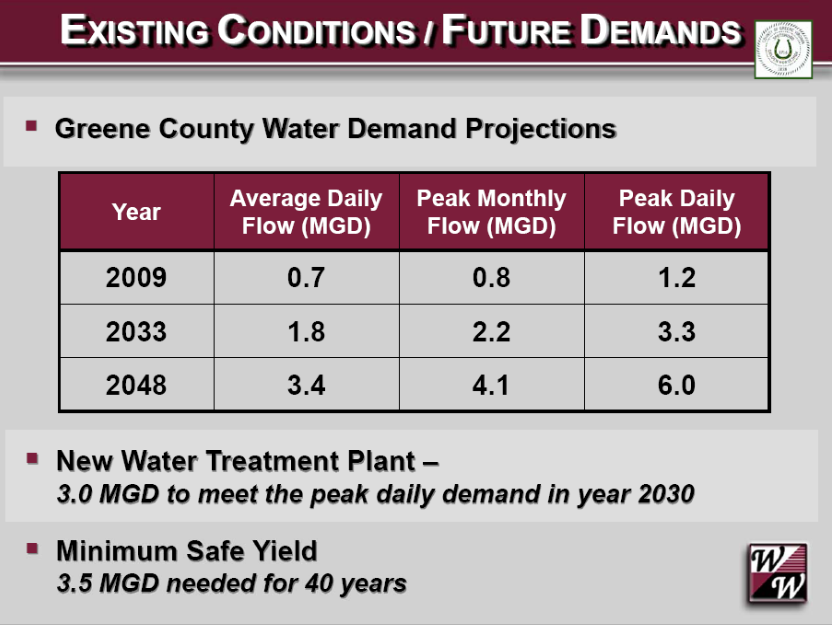

Greene County anticipated in 2008 that in 40 years, it would need 3.4 million gallons/day (MGD)
Greene County anticipated in 2008 that in 40 years, it would need 3.4 million gallons/day (MGD)
Source: Greene County, Greene County Water Supply and the White Run Reservoir Project (from Regional Water Supply Study, April 22, 2008)

The 75' high dam on White Run would block a small tributary. That small watershed would not produce enough water fill the 900 million gallon reservoir and to supply 3.5 MGD reliably. The plan involved pumping 10%-15% of the daily flow from the Rapidan River up to White Run, through a pipe with its intake adjacent to the current Rapidan Service Authority water treatment plant.

Pumping would be seasonal, because during the summer the supply in the Rapidan River is limited. The existing Rapidan Service Authority water treatment plant had priority. Based on a safe yield analysis completed in 1985, it was already authorized to withdraw up to 1.15MGD:2

In the dry times of summer, it is likely that no water will be withdrawn because 10%-15% of the daily flow is inadequate to fill the raw waterline from the river to the proposed reservoir. During the winter, however, the withdrawal will be up to the proposed design capacity of 10 MGD when the reservoir is being refilled.

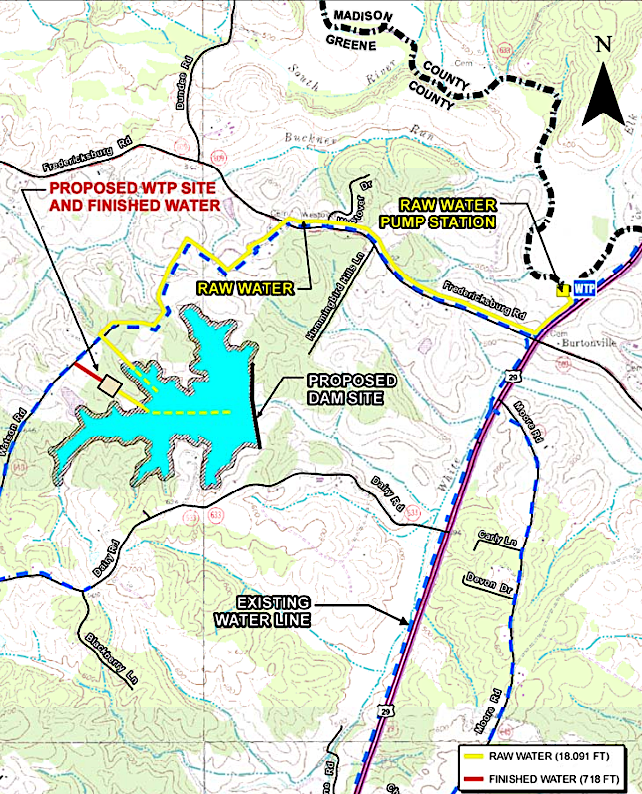

Greene County and Stanardsville planned to pump water from the Rapidan River to the new reservoir on White Run
Greene County and Stanardsville planned to pump water from the Rapidan River to the new reservoir on White Run
Source: Greene County and the Town of Stanardsville, 2001 Joint Permit Application for a Pumped Water Reservoir (Figure 1-1)

Greene County purchased the property needed for the White Run Reservoir in 2011. The Rapidan Service Authority agreed to collect a special "facility fee" from Greene County residents to fund the White Run Reservoir project, which would benefit just Greene County residents. By 2020, $11 million had been collected, and Greene County planned to increase it in order to finance construction of the reservoir. In a surprise vote with no advance notice, the four members from Madison and Orange counties decided to stop collecting the facility fee rather than to increase it.

The four members proposed that all of the Greene County taxpayers should fund more of the cost, rather than just the current and future ratepayers buying water and sewer services from the regional authority. The General Manager of the Rapidan Service Authority floated an alternative to the $35 million White Run impoundment project. He claimed Greene County had overstated its projected demand, and that installing a membrane filtration system in the current water treatment plant could add 3-4 MGD capacity and meet his projection of demand for around $10 million. However, the proposal with no new reservoir assumed there would always be adequate flow in the Rapidan River throughout the summer months to withdraw extra water from the river.

The vote to cancel collection of the facility fee undermined the ability of Greene County to proceed. County officials pushed back against claims that progress was too slow to justify continuing to collect the fee, noting that the reservoir site had been purchased and engineering plans for the dam, pipeline, and other facilities had been prepared. When a Green County official emphasized that the sudden proposal of the Rapidan Service Authority had not been vetted and the White Run project was part of a long-range plan, a Madison County member of the authority's board responded "...you've done nothing."

The Rapidan Service Authority had built a water system for portions of Greene County, and the authority had plans for $12 million in improvements for the town, but the plans were just on paper. Over 50 years after creation of the regional water system, the Town of Stanardsville still lacked a reliable supply of water. In 2021, the Grene County Administrator stated:3

Stanardsville lacks the water capacity and water pressure to fight a fire. Opening a single fire hydrant has left a neighborhood without enough water to take a shower or fill a pot... Of the 265 fire hydrants on the RSA water system in Greene County, it is estimated that more than a third of the hydrants won't work.

...It should also be noted that while the facility fee was paid only by water users, 7.5 cents worth of the real estate tax paid by all Greene County taxpayers is used to pay for water and sewer infrastructure.

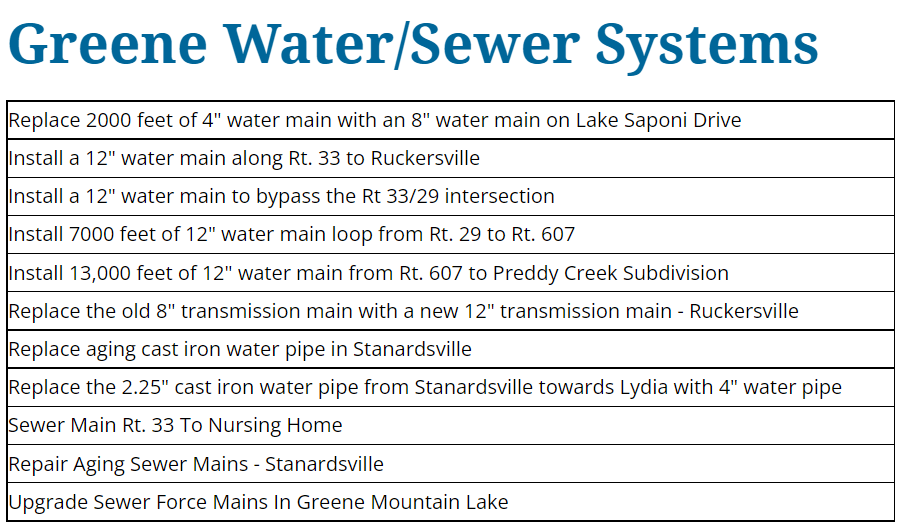

when Greene County withdrew from the Rapidan Service Authority in 2022, 11 major projects were planned in the county
when Greene County withdrew from the Rapidan Service Authority in 2022, 11 major projects were planned in the county
Source: Rapidan Service Authority, Proposed Projects

Greene County's supervisors quickly determined it was in their interest to create a county-managed water and sewer authority, and voted to withdraw from the Rapidan Service Authority. That move was delayed when the Board of Supervisors in both Orange and Madison county refused to allow Greene County to withdraw, so Greene County filed a lawsuit claiming breach of contract.

Rapidan Service Authority meetings became toxic. In a 4-2 vote, the representatives from Orange and Madison County decided that the two Greene County representatives would no longer be allowed to speak or vote, so budget and policy decisions would be made without their participation. In response, Greene County filed another lawsuit to force dissolution of the regional authority. It claimed state law required the board to have at least five members, and exclusion of the two Greene County representatives left the board with just four members.4

The issue was complicated in part because the authority had used the Virginia Resource Authority to issue bonds. Breaking up the authority required clarifying first who would be responsible for what portion of that debt.

In 2021, the supervisors in Orange and Madison county reversed their position and agreed to allow Greene County to withdraw. The Rapidan Service Authority would continue, with more than 5,000 customers in Orange County had more than 5,000 customers and less than 200 in Madison County. Despite those decisions by the electd supervisors, the appointed members on the board of the Rapidan Service Authority still refused to authorize withdrawal. Greene County won the procedural votes in court as its lawsuits continued, and the elected officials in all three counties viewed the board of the Rapidan Service Authority as obstructing a resolution.5

In 2022, recognizing Greene County was winning the lawsuits, all three counties and the Rapidan Service Authority negotiated a withdrawal and transition agreement that was formally adopted. Greene County Water & Sewer could finally be created.

The Virginia Resource Authority concurred in January and the State Corporation Commission agreed to the breakup in June 2023. The Rapidan Service Authority continued, with Orange County having three board members and Madison County appointing two.6

Greene County created the Greene County Water & Sewer Department in 2023. During the startup phase water rates increased by 150% and customers complained about erratic, late bills. Future costs included $25 million for replacing the Stanardsville water lines and $40 million for the water treatment plant, plus potentially $100 million to construct the proposed White Run Reservoir Water Impoundment Project to increase water supply.

Of the county's 21,000 residents, only about one-third were customers of the water and sewer utility. If all projects were built, each ratepayer would have to cover $25,000 in capital costs.7

In December 2024, the supervisors in both Greene and Orange counties approved holding discussions on building the White Run Reservoir, plus a water treatment plant and the pipe/pumping station infrastructure to distribute drinking water. By then the estimated cost was $76 million to construct a reservoir that would supply 3.0 million gallons/day (MGD) to meet average demand.

The Rapidan River would be the primary source for the reservoir, not groundwater or the small White Run stream. The river could supply only 0.9MGD on a reliable basis. No matter how severe a drought might be in the future, Greene County was not going to be authorized by the Virginia Department of Environmental Quality (DEQ) to suck away all the water and leave no instream flow for fish and other aquatic life. Filling the reservoir initially, and refilling after drawdowns, would require pumping water intermittently during times of high Rapidan River flow.

There was a deadline for action. The 401 Water Withdrawal Permit from the Virginia Department of Environmental Quality (DEQ) expired on March 12, 2028. The Section 404 permit from the US Army Corps of Engineers expired on June 13, 2028. Construction and initial filling was expected to require three years.

A short-term partnership between Orange and Greene counties reflected their different needs. Greene did not anticipate a need of an additional 3.0 MGD for many years, but Orange County was looking for a quick source of water. Orange County funding would make the White Run Reservoir project economically feasible by 2028, with Orange County using 1/3 of the capacity. The supervisors anticipated that as Greene County's demand increased over time, Orange County would then build its own, separate reservoir.

The Greene County Administrator said:8

Sharing the financial side of this would strengthen our position even more... Once we have our reservoir built, we won't need it at full capacity on Day One; Orange County has an immediate need for water.

She also said, well aware of the experience with the Rapidan Service Authority, said:9

This will allow us to stay in the driver's seat, whether we do [the agreement] or not.

Drinking Water in Virginia

Greene County

Madison County

Orange County

Waste Management in Virginia

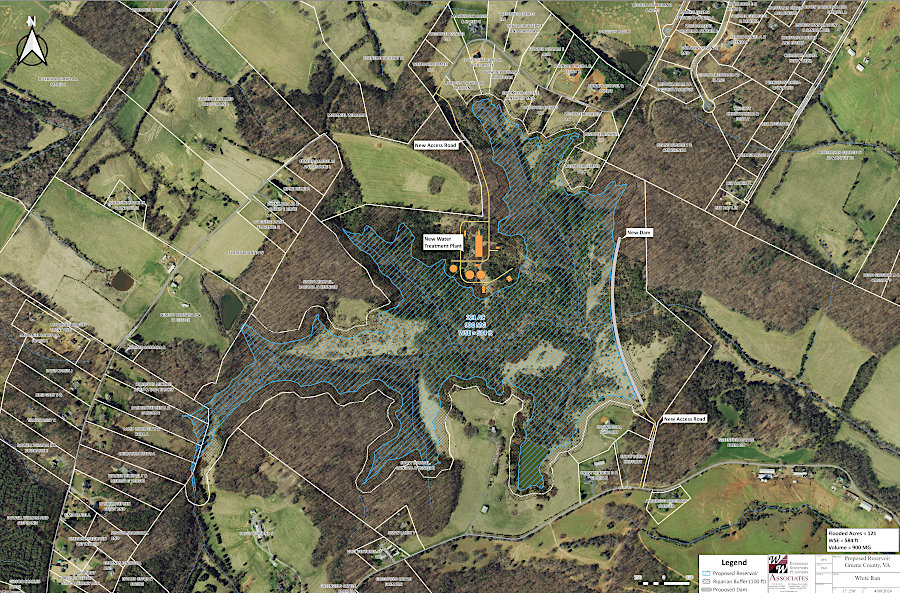

the proposed White Run Reservoir
the proposed White Run Reservoir
Source: Greene County, White Run Reservoir and Water Treatment Plant Drawing

Links

References

1. "Guest Editorial: The story of Greene County & Rapidan Service Authority," Daily Progress, August 28, 2021, https://dailyprogress.com/community/greenenews/opinion/guest-editorial-the-story-of-greene-county-rapidan-service-authority/article_68fb5830-05bb-11ec-810f-57a0e329ce0b.html (last checked April 17, 2024)
2. "About RSA," Rapidan Service Authority, https://www.rapidan.org/about-rsa; "Regional Water Supply for Greene County and the Town of Stanardsville," WW Associates, December 8, 2009 and revised February 11, 2001, p.E-1, p.E-2, https://www.greenecountyva.gov/how-to/forms/admin/white-run-reservoir/915-regional-water-supply-plan-summary/file; "2001 Joint Permit Application for a Pumped Water Reservoir," Greene County and the Town of Stanardsville, 2001, p.8, p.19, p.23, p.30, http://www.greenecountyva.gov/how-to/forms/admin/white-run-reservoir/965-joint-permit-application-pumped-storage-reservoir-greene-co-ww-associates-vol-i/file (last checked July 8, 2022)
3. "Greene County dismayed as RSA takes reins on water improvement project, does away with facility fees," WVIR, July 20, 2020, https://www.nbc29.com/2020/07/20/greene-county-dismayed-rsa-takes-reins-water-improvement-project-does-away-with-facility-fees/; "Developing: Greene County BOS votes to withdrawal from RSA," Greene County Record, July 28, 2020, https://dailyprogress.com/greenenews/news/developing-greene-county-bos-votes-to-withdrawal-from-rsa/article_a80319d6-d138-11ea-bfea-6b7871734f67.html; "Greene reps question proposed RSA water rate increase," Daily Progress, August 25, 2020, https://dailyprogress.com/community/greenenews/news/greene-reps-question-proposed-rsa-water-rate-increase/article_49e00c7e-e6cd-11ea-a485-e7d5ea8c0203.html; "Guest Editorial: The story of Greene County & Rapidan Service Authority," Daily Progress, August 28, 2021, https://dailyprogress.com/community/greenenews/opinion/guest-editorial-the-story-of-greene-county-rapidan-service-authority/article_68fb5830-05bb-11ec-810f-57a0e329ce0b.html (last checked July 8, 2022)
4. "Greene BOS files second lawsuit against RSA," Green County Record, October 1, 2020, https://dailyprogress.com/community/greenenews/news/greene-bos-files-second-lawsuit-against-rsa/article_6c51c906-0409-11eb-8388-47961745d7cd.html (last checked July 8, 2022)
5. "Greene’s RSA exit given OK," Greene County Record, April 22, 2021, https://dailyprogress.com/community/greenenews/news/greene-s-rsa-exit-given-ok/article_9501036a-a2ad-11eb-b04c-f75b0d742318.html; "RSA sees budget argument, resignation, lawsuit appeal in December," Greene County Record, January 6, 2022, https://dailyprogress.com/community/greenenews/news/rsa-sees-budget-argument-resignation-lawsuit-appeal-in-december/article_dae4006e-6e2f-11ec-a711-c71005034663.html (last checked July 8, 2022)
6. "Record-Breaking Meeting Brings Closure For Greene County And RSA," MadRapp, July 6, 2022, https://madrapp.com/recordbreaking-meeting-brings-closure-for-greene-county-and-rsa-p3708-175.htm; "Exit approved," Daily Progress, June 22, 2023, https://dailyprogress.com/news/community/greenenews/exit-approved/article_4884ecce-0f7d-11ee-a809-1b9038c98118.html (last checked June 22, 2023)
7. "Fledgling Greene County Water & Sewer drowning in debt, customer complaints," Daily Progress, April 16, 2024, https://dailyprogress.com/news/community/madisonnews/fledgling-greene-county-water-sewer-drowning-in-debt-customer-complaints/article_8204310e-fc02-11ee-9ccc-9302088d4567.html (last checked April 17, 2024)
8. "Greene, Orange counties could share future reservoir," Green County Record, December 17, 2024, https://dailyprogress.com/news/community/greenenews/greene-orange-counties-could-share-future-reservoir/article_4b8653e8-b8e3-11ef-a065-a32ad3123d53.html ; "Water Supply and Treatment Project," Greene County Board of Supervisors Meeting, March 26, 2024, https://greenecountyva.gov/DocumentCenter/View/142/Water-Supply-and-Treatment-Project-Presentation---March-26-2024-PDF; "Greene County has less than five years until permit expires to build new reservoir," Information Charlottesville, October 15, 2023, https://infocville.com/2023/10/15/greene-county-has-less-than-five-years-until-permit-expires-to-build-new-reservoir/ (last checked December 19, 2024)
9. "Greene and Orange counties consider joint reservoir - but not forever," WVIR, December 12, 2024, https://www.29news.com/2024/12/13/greene-orange-counties-consider-joint-reservoir-not-forever/; (last checked December 19, 2024)
